Danger on the Line: Damning safety findings that put passengers and train drivers at risk

stream_img

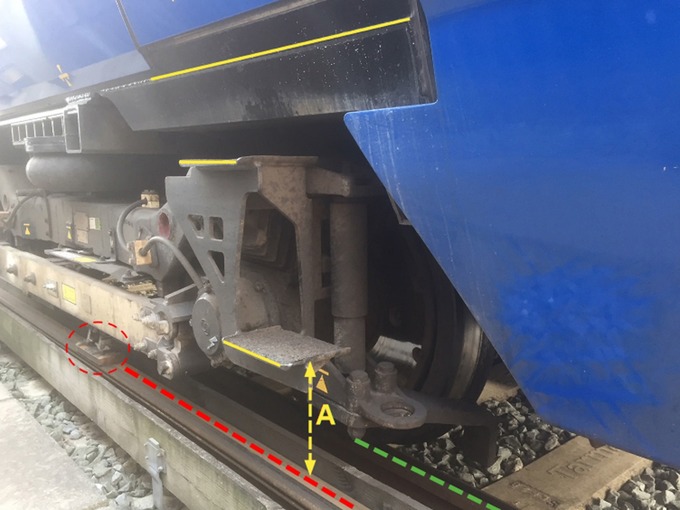

People had to step over this live rail to get off the train. It didn’t even have a protected board at the time Pic credit: Aviva Trains

CROSS POSTED ON BYLINE.COM

A  damning report was published this month by the Rail Accident Investigation Branch into an incident nearly a year ago which led to 450 passengers being urged to leave a stranded train and walk along the tracks within inches of a live high voltage electric rail.

The report is not only critical of this incident but raises the question whether there are systemic failures in our semi privatised railways which need urgently addressing. It reveals a string of other incidents that have happened in the last five years.including two cases where express train drivers had to lie under their trains to avoid being mowed down by trains coming in the opposite direction.

These include;

A Virgin Express train driver had to cower under his Inverness to London express just north of York to prevent being mowed down by a 105mph express in the opposite direction. The trainee signalman had failed to tell the driver of the stopped train that he had not halted other trains in the area.

Exactly the same thing happened again at Stafford six months ago when a Manchester to London Virgin express stopped because of a fault. The driver who was badly shaken had to hide under the train to avoid being run over by an express coming in the opposite direction.

Passengers getting out on to the tracks at Gospel Oak and waking to the station in 2013 – and a suburban train going forward without permission to take passengers off at Hackney Downs and almost overrunning a junction where it could have crashed into a train coming in the opposite direction.

Figure_2

You can just see the driver nearly under the Virgin Train north of York from this CCTV picture. Pic Credit: Virgin Trains

This latest report  was about a passenger train that was halted outside Peckham Rye station in South London last November after a fault automatically stopped the train.

The driver , who did not have a guard, got the go ahead from the private operator Aviva’s control centre to get passengers off the train. As the report says:

“This involved passengers climbing down vertical steps to ground
level, very close to the live electric conductor rail (third rail) and walking along the side
of the line for about 30 metres to Peckham Rye station.

“Soon afterwards, an operations manager from Govia Thameslink Rail, which manages
Peckham Rye station, contacted the member of station staff and realised where they
were and what was happening. The operations manager immediately instructed
the driver to stop the evacuation, and requested that he contact the signaller and
his company’s controller for further instructions. ”

…”The train driver and the signaller did not reach a clear understanding
about the actions that were required to safely detrain the passengers. The delay
caused unrest among the passengers on the train and contributed to stress and task
overload of the driver, which affected his decision making. The driver’s experience
and skills did not enable him to cope with these demands, and Network Rail did
not effectively implement its own procedures for managing an incident involving a
stranded train.”

The scandal revealed here is the lack of communication between Aviva’s control centre, Network Rail, the signalman, which all put passenger safety at risk.

Of course both Network Rail and Aviva have said they have taken measures to deal with it. But the report reveals that in Aviva’s case very little has been done – particularly at its control centre. Inspectors returned after the incident and found:
l the environment within the control room was noisy and poor equipment was still
being used, both of which may cause distraction, and the floor plan was still too
small;
2 poor communications (verbal / IT systems and written notes) were observed
and still evident;
3 a lack of coordination and awareness of the different roles within the control
room was still evident”

Simon French,Chief Inspector of Rail Accidents concluded: “Following previous incidents, the railway industry has put in place policies for managing incidents in which trains become stranded. This incident has shown that when things go wrong, these policies may not be effective. …. We are recommending that, both locally and nationally, the incident management arrangements should be reviewed, and processes put in place to exercise them regularly. It’s not enough to have a plan – it must work when it is needed, and if it has never been practised the chances are it won’t work.”

The report on Peckham Rye can be read in full here  and the reports on the Virgin train incidents can be read here and here.

You are paying £2.5m to keep this tram train in a depot

Rotherham train tram south yorkshire

The Rotherham train tram – staying in the depot until next year

CROSS POSTED ON BYLINE.COM

This is the new Sheffield to Rotherham tram train. It should have been in service over a year ago. Instead it is going nowhere. It is one of seven train trams  confined to a depot and won’t go into service until next May at the earliest.

As a taxpayer you are paying the private rail and bus company  Stagecoach £2.5m compensation for a service it can’t run because Network Rail haven’t completed the job on time.

But the £2.5m is small beer to another much bigger bill you are paying Network Rail to adapt a route both extending tram tracks and using a disused railway track to create the new service from Sheffield to Rotherham.

That bill is now nearly five times what was originally estimated -it has gone from £18.7 m to £75.1m – a staggering increase on the original projected cost.

Details of this scandal are published in a report by Parliament’s financial watchdog, the National Audit Office and will no doubt be examined by MPs on the Commons public accounts committee later this year. I have written about it in Tribune magazine today.

The project is important because it is a pilot scheme and if it is successful lead to other tram train projects in Glasgow to the airport and in the South Wales valleys outside Cardiff.

The bungling of the project – originally approved by two Liberal Democrat ministers, Norman Baker and Danny Alexander – as  a worthy new public transport scheme has infuriated Sheffield Labour MP Clive Betts who has put the whole blame on bad management by Network Rail.

tt02

A Karlsruhe tram train : In operation since the 1980s on streets and mainline railways. Pic credit : random streets blogspot

The scheme which was nearly cancelled twice however should not have been rocket science. Tram trains have existed in Germany – Karlsruhe was the first city to have one – since 1980 yet according to the MP Network Rail couldn’t be bothered to consult them to get advice  before they started.

Another big failing was not to appreciate that the tram trains might require two different electrification systems and a failure to appreciate how much work was needed on the railway lines to bring them back into public service – including the need to alter a junction.

Rob McIntosh, Network Rail’s London North Eastern and East Midlands Route Managing Director, said: “Sheffield to Rotherham tram-train is an ambitious pilot, a UK first, that will bring new travel choices to people of South Yorkshire when services begin in 2018. The project continues to be complex and challenging but will deliver real benefits for thousands of daily commuters.

…”the project has been extended to include additional work to future-proof the tram-train electrification system for later conversion to the national rail standard system that was  not part of the original scope. Such factors have added time and cost to the pilot which is under significant pressure  to deliver.”

However this is still another sorry saga and could impact on future projects. Plans are now going ahead for a £144m tram train link from Glasgow’s Queen Street station to Glasgow Airport using the same technology. Whether this will also overrun remains to be seen.
